Private Estimates
This guide explains how to use Private Estimates in FastDraft, including:
- What Private Estimates are and when to use them
- How to enable Private Estimates within a contract template
- How to create and manage Private Estimates
- Understanding the Privacy List and controlling user access
- Using Privately Estimated Final Price and Completion views
- Updating and superseding Private Estimates
- How quotations interact with Private Estimates
- Preventing duplicate impacts through change lineage
- Configuring Early Warning and Instruction relationships
- Frequently asked questions and best practice recommendations
Overview
In many contract management systems, contract values and completion dates only change once information has been formally submitted, quoted, assessed or agreed.
However, there can be a significant delay between:
- An Early Warning being raised.
- A Compensation Event being notified.
- A quotation being received.
- A quotation being agreed or an assessment being issued.
During this period, the project team may already expect a commercial or programme impact, but this may not yet appear in the contract value, forecast outturn cost or completion date. This can mean that emerging costs and risks are not visible early enough in project reporting.
Private Estimates allow your organisation to record its internal assessment of the likely cost and time impact while the formal quotation process is ongoing. They can be added against a notice, such as a Compensation Event, before a formal quotation is received,
Important: Private Estimates are visible only to authorised users within your organisation. They are not shared with the other party to the contract.
Why use a Private Estimate?
Private Estimates help project teams capture their internal assessment directly in FastDraft rather than relying on separate spreadsheets, forecasting tools or informal discussions.
This provides earlier visibility of potential financial and programme exposure while the formal quotation is being prepared.
Private Estimates can help your organisation:
- Improve forecast accuracy before a formal quotation is received.
- Record an internal view of potential cost and completion impacts.
- Update the estimate as more information becomes available.
- Retain a history of previous estimates.
- Replace or supersede estimates as the contractual position changes.
Enabling Private Estimates
Private Estimates are enabled through the relevant contract template or master template, to review or change this setting, you need to have suitable FastDraft administrator access.
To review or change the setting:
- Open the relevant contract template.
- Select the Compensation Events workflow group.
- Open each relevant workflow.
- Set Private Estimates Enabled to On or Off.
- Select Update Workflow after changing each workflow.
- Select Update Workflow Group.
- Select Save Changes.
Once enabled, authorised users can create Private Estimates against Compensation Events on contracts that use the template.
Creating a Private Estimate
To create a Private Estimate:
- Open the relevant contract.
- Go to the Compensation Events workflow.
- Open the Compensation Event you want to estimate.

- Select the Private Estimates tab.
- Select Create New.
- Enter the estimated financial impact.
- Where available, enter the estimated impact on completion.
- Add any supporting information required by your organisation.
The Private Estimates tab is available within the Compensation Event.
From this page, you can view the Private Estimate Register and open the Privacy List.
Select Create New and complete the available fields.
The form can include:
- Price Impact: The estimated change in cost.
- Time Impact: The estimated effect on the completion date.
- Internal Notes: Optional commentary explaining the basis of the estimate.

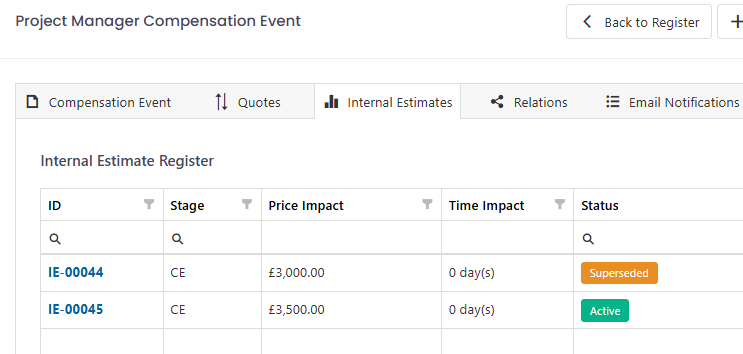

Once created, the new Private Estimate appears in the register with a status of Active.
Managing access with the Privacy List
Select Privacy List from the Private Estimate Register to view the users who can access the Private Estimates.
For General users
- The first person to create a Project Manager Private Estimate becomes the Privacy List Administrator for the whole contract. Note: To create or access Private Estimates, the user must be associated with the Project Manager (PM) party and assigned to the PM party on the contract. The PM party on the contract must also belong to the same company shown as the Project Manager on the contract dashboard. Users from other parties or companies will not be able to access Private Estimates.
- The Privacy List Administrator can grant or revoke access for contract users linked to the Project Manager company shown in the contract overview.
- Access can also be provided to administrators linked to that company.
- Other users included on the Privacy List can see who has access, but they cannot change the list or view other potentially eligible users.
For Privacy List Administrator
- If you are the Privacy List Administrator for the contract, you can view existing users with access, eligible users, and the grant and revoke controls.
- You can also assign a new Privacy List Administrator.
- If you are not the Privacy List Administrator, you can view existing users with access and assign a new Privacy List Administrator.
Privately Estimated Final Price and Completion
The Privately Estimated Final Price and Privately Estimated Final Completion pages are available within the contract settings menu.
These pages show the projected final price and completion date. The projections combine the current price and completion date, including implemented changes, with quoted or estimated impacts that have not yet been formally agreed or assessed.
Privately Estimated Final Price
Select the link in the Logs column to view the activity and its effect on the projected price.
Privately Estimated Final Completion
Select the link in the Logs column to view the activity and its effect on the projected completion date.
Updating a Private Estimate
Update the Private Estimate as further information becomes available.
Keeping the estimate current helps ensure that forecasting reflects your organisation’s latest understanding of the Compensation Event.
Superseding a Private Estimate
Adding a new estimate automatically supersedes the previous estimate.
The following rules apply:
- When a quotation is received, the formal quotation supersedes the Private Estimate.
- If a new estimate is added after a quotation is received, the new estimate supersedes the quotation when FastDraft calculates the Privately Estimated Final Price and Privately Estimated Completion Date.
- An estimate that is no longer current can also be marked as superseded manually.
When an estimate is superseded:
- It is no longer treated as the current estimate for that item.
- If another quotation or estimate exists for the item, that value is included instead when calculating the privately estimated price or completion.
- The previous estimate remains in the event history.
Important: Marking an estimate as superseded does not necessarily remove the estimated impact from the calculation. If you need to remove the current impact completely, create a new zero-value estimate for the item.
When a formal quotation is received
A Private Estimate supports internal forecasting while the formal value is unknown. It does not replace the formal quotation or contractual assessment process.
When a quotation becomes available, FastDraft uses the quoted values instead of the estimated values when calculating the privately estimated final price or completion.
At this stage, review the Private Estimate to make sure:
- The correct quotation or estimate is being used.
- An outdated estimate is not continuing to affect the forecast.
- Superseded values have been handled correctly.
- The forecast reflects the latest contractual position.
- A new Private Estimate is created where this would more accurately reflect the expected final position.
Avoiding duplicate estimates
Private Estimates can also be enabled for Project Manager Instructions and Early Warnings. However, for the initial rollout, it is recommended that they are enabled for Compensation Events only.
This keeps the process straightforward and reduces the risk of the same potential impact being estimated more than once across related workflows.
If Private Estimates are enabled earlier in the contractual process, related communications must be connected using a change lineage.
For an estimate to carry forward, the previous communication must be selected on the current notice when it is created. Creating a relationship manually does not have the same effect.
Supported sequences
For an NEC4 ECC contract, the typical sequence is:
Early Warning → Project Manager Instruction → Compensation Event
The following sequences are also supported:
- Early Warning → Project Manager Instruction
- Early Warning → Compensation Event
- Project Manager Instruction → Compensation Event
Allowing an Early Warning to be selected on a Project Manager Instruction
To allow users to select a previous Early Warning when creating a Project Manager Instruction:
- Open the relevant contract template or master template, to review or change this setting, you need to have suitable FastDraft administrator access.
- Open the Instructions workflow group.
- Go to the Placeholders tab.
- Add the EWRelationEnabled placeholder.
- Set the placeholder to Yes.
This adds an Early Warning selector to the Project Manager Instruction form.
Allowing an Early Warning to be selected on a Compensation Event
To allow users to select a previous Early Warning when creating a Compensation Event:
- Open the relevant contract template or master template, to review or change this setting, you need to have suitable FastDraft administrator access.
- Open the Compensation Events workflow group.
- Go to the Placeholders tab.
- Add the EWRelationEnabled placeholder.
- Set the placeholder to Yes.
Allowing a Project Manager Instruction to be selected on a Compensation Event
To allow a previous Project Manager Instruction to be selected on a Compensation Event:
- Open the Fields placeholder for the Compensation Event workflow.
- Enable the Instructions field.
- Give the field a suitable label, such as $WF_4_NOTIFICATION_NAME
Together, these settings add the relevant selectors to the Compensation Event form.
If these fields are not added, users cannot create a change lineage. If the previous communication is not selected when the notice is created, no change lineage is established.
Without a change lineage, estimates against each notice contribute separately to the Privately Estimated Final Price and Privately Estimated Completion Date. This may result in the same impact being counted more than once.
Important: A change lineage cannot be created retrospectively. If related items were not connected when they were created, Private Estimates against each communication will count separately. Where appropriate, this can be corrected by creating zero-value estimates against the earlier communications.
Recommended steps to prevent duplicate impacts
To reduce the risk of double-counting:
- Initially use Private Estimates against Compensation Events only.
- Configure the contract template so that users can create a change lineage.
- Ensure users understand that they must select the previous communication when issuing the new notice.
- Check whether an estimate already exists for the same issue.
- Review privately estimated values before using them in portfolio or management reporting.
- If a lineage was not created, add a zero-value estimate against the earlier Early Warning or Project Manager Instruction where appropriate.
Frequently asked questions
Is a Private Estimate shared with the other party?
No. Private Estimates are intended for internal forecasting and do not form part of the formal quotation exchanged between the parties.
Does a Private Estimate replace the formal quotation?
No. It provides an internal estimate while the formal quotation is unavailable. The usual contractual quotation and assessment process still applies.
Can an estimate be changed?
Yes. Update the estimate as additional information becomes available.
What happens when I supersede an estimate?
The estimate is no longer treated as the current estimate. If another quotation or estimate exists for the same item, that value may be used instead in the privately estimated calculations.
How do I remove an estimated impact?
Create a new zero-value estimate for the item. Marking the existing estimate as superseded may cause another available quotation or estimate to be used instead.
Why can I not see the Private Estimates option?
The feature may not be enabled in the contract template. Contact your Site Administrator or Company Administrator to check the template configuration.
Can Private Estimates be used for Early Warnings or Instructions?
Yes. However, it is recommended that the feature is initially enabled for Compensation Events only. This simplifies the process and reduces the risk of duplicate estimates.
Do I need to enable Private Estimates for every contract?
This depends on how your contract templates are configured. If several contracts use the same master template, enabling the feature within that template may apply the configuration to all associated contracts. Contracts using individual templates may need to be updated separately.
Summary
Private Estimates provide earlier visibility of the likely cost and programme impact of Compensation Events before a formal quotation is received.
For the simplest rollout, enable Private Estimates for Compensation Events only. Once users are familiar with the functionality and your change-lineage configuration has been reviewed, you can consider extending it to Early Warnings and Project Manager Instructions.
